Merlin Next (RERA HIRA/P/KOL/2020/000987): price, possession and the verified record

Merlin Next is a 1.1095-acre, 132-unit project by Merlin Group at Behala, registered with WB RERA as HIRA/P/KOL/2020/000987 and listed at 2060000 - 3300000. Possession is the one thing the record does not agree on: the promoter’s own filing declares 31 Dec 2025, the authority’s current record shows Dec 2025.

No conflicts found7 approved documentsReviewed 2026-07-30
2060000 - 3300000Price band
132Units registered
1.1095 acRegistered area
Dec 2025Latest declared completion2 sources disagree
—Declared project cost

Is Merlin Next RERA approved?

Yes. It is registered with WB RERA under HIRA/P/KOL/2020/000987, covering 1.1095 acres with 132 residential units and 1 recorded approvals.

  • Building plan approvalApproved · 22/08/2020
  • AAI height clearanceNot in the reviewed filing
  • Environment clearanceNot in the reviewed filing
  • Fire scheme approvalNot in the reviewed filing
  • Consent to establishNot in the reviewed filing
  • Occupancy certificateNot expected until completion

Source: WB RERA registration certificate HIRA/P/KOL/2020/000987.

When is possession at Merlin Next?

There are 2 different dates on record. The promoter committed to 31 Dec 2025 in its own RERA filing. The authority’s current public record shows Dec 2025.

31 Dec 2025
binding
Certificate-declared completion date
This is the HIRA certificate date and is past at review date; it is not evidence of completion or occupancy.
Dec 2025
binding
The promoter's own RERA filing
Declared by the promoter in Form REP-I — the strongest commitment on record.

None of these is an occupancy certificate. A declared completion date is what the promoter filed, not proof of delivery. What to ask for: Request a current regulator status record and any project-specific extension, correction or close-out instrument for HIRA/P/KOL/2020/000987.

Source: the promoter's RERA filing (Form REP-I) and the authority's registered-project index.

What is the price of Merlin Next?

Publicly listed at 2060000 - 3300000. No dated, unit-specific price list was sourced against this registration, so treat the band as indicative rather than an offer.

Amenities on record

  • Power Backup
  • Swimming Pool
  • Lift
  • Security
  • Park
  • Gymnasium
  • Indoor Games Room
  • Meditation Area
  • Multipurpose Hall
  • CCTV Camera
  • Entry Exit Gate
  • Fire Fighting Equipment
  • Yoga
  • Spa
  • Kids Play Area
  • Garden
  • Intercom

Source: the filed unit schedule. Price band from public listings; not promoter-confirmed.

Who is the developer of Merlin Next?

The promoter on record is Merlin Projects Limited, marketed as Merlin Group, registered at 22 Prince Anwar Shah Road ,.

Source: the authority's promoter disclosure and the filed financial schedule.

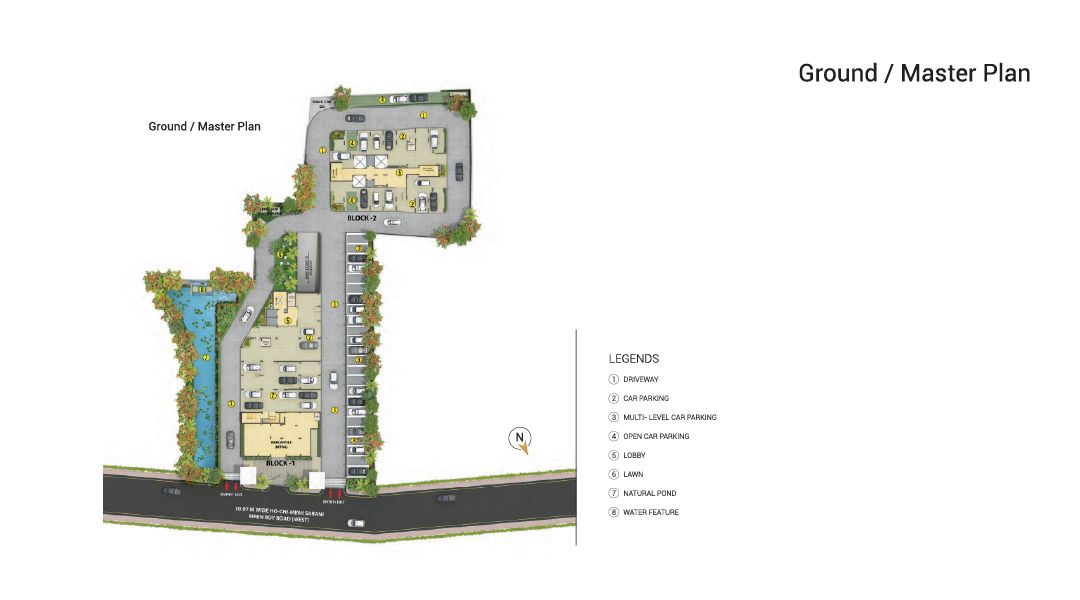

What do the approved plans for Merlin Next show?

The layout, floor plans and elevations the promoter publishes. These are promoter-issued sheets, not documents lodged with WB RERA — treat the dimensions on them as indicative until you see the sanctioned set.

Source: 0 filed under this registration, plus promoter-issued sheets reviewed for provenance.

Is it safe to buy in Merlin Next?

The registration itself is sound — identity, scope and phase all check out. 3 things are still open. Resolve that before you pay.

Past HIRA date needs current authority confirmation
The certificate date of 31 December 2025 has passed, and this review did not obtain a current HIRA status extract or a project-specific extension instrument.
What to ask for: Request a current regulator status record and any project-specific extension, correction or close-out instrument for HIRA/P/KOL/2020/000987.
No completion or occupancy certificate reviewed
The reviewed material includes permit and commencement evidence, but no certificate establishing full completion or occupancy. Third-party delivery labels do not resolve the gap.
What to ask for: Obtain the relevant completion and occupancy documents from the competent authority and match them to Block 1 or Block 2 and the selected unit.
HIRA/WBRERA regime label is not a duplicate by itself
The project carries a HIRA registration. No matching WBRERA number was established in this review, and later portal changes do not by themselves prove a replacement registration.
What to ask for: Use the HIRA certificate and a current regulator response to trace any successor or amended record.

Source: Site Setu agent-reviewed dossier, 2026-07-30. Record-quality assessment, not investment advice.

The verified record behind this page

Every figure above comes from a document filed with WB RERA. This is the audit that produced them — 4 dimensions assessed, every fact carrying its own confidence.

Record review

Agent-reviewed 2026-07-30 · 7 facts checked · 4 dimensions

Registration identity
Supported
HIRA certificate supplies a distinct registration
Registered scope
Supported
Two 66-apartment blocks
Timeline
Needs a look
Certificate date is past
Occupancy
Not sourced
No close-out certificate reviewed
HIRA registration
Hira/P/Kol/2020/000987The HIRA certificate identifies Merlin Next, with NPR-01484/procode 19888000000009 in the extracted authority record.
high
Legal promoter
Merlin Projects LimitedThe HIRA certificate and filed material identify Merlin Projects Limited (CIN U70109WB1984PLC038040).
high
Registered inventory
132 apartments across Block 1 and Block 2Filed carpet material records 66 apartments in each block. This is not current availability.
high
Filed configurations
2- and 3-bedroom variantsThe carpet schedule includes 2BHK+2T and 3-bedroom variants across the two blocks. It does not establish current price, sale stock or handover.
high
KMC permit and commencement filings
Building permit 2020140110 dated 22 August 2020; commencement letter filedThese documents support regulatory filing history but do not establish completion or occupancy.
high
Certificate-declared completion date
31 December 2025The date stated in the HIRA certificate is past at review date. A current HIRA public status extract was not reviewed.
stale
Completion and occupancy evidence
Not reviewedNo completion certificate or occupancy certificate was located in the reviewed HIRA material. Portal and brokerage delivery labels are not treated as a substitute.
not-found
▸ How this review was done, and what it excluded
Authority
WB RERA
Registration
HIRA/P/KOL/2020/000987
Documents seen
7 drawing sets, 0 authority documents
3D reconstruction
Not built
Not established
Occupancy certificate, current construction progress, live inventory, dated unit-level offer

Source: HIRA registration certificate and filed documents, KMC permit record, local extraction record, and promoter website

The same filings, as a working project plan

A RERA filing already contains a programme, a cost plan, an approvals register and a drawing register — just locked inside PDFs. This is that filing rendered as a live Site Setu workspace, with nothing added.

Merlin NextDemo · read only

Overview

Merlin Next

From the RERA filing
1.1095 ac
Registered area
1
Approvals on file
of 6 typical
7
Documents on file
plans, approvals, legal
Dec 2025
Completion
disputed · 2 sources
Completion date is unresolved. The promoter’s own filing declares 31 Dec 2025, the authority’s public record shows Dec 2025. Nothing in the reviewed filings explains the change. In a live workspace this would sit as a blocking issue against the handover milestone, with an owner and a due date.

Record timeline

  1. 31 Dec 2025Certificate-declared completion dateThis is the HIRA certificate date and is past at review date; it is not evidence of completion or occupancy.
  2. Dec 2025The promoter's own RERA filingDeclared by the promoter in Form REP-I — the strongest commitment on record.

Project card

Promoter
Merlin Projects Limited
Registration
HIRA/P/KOL/2020/000987
Authority
WB RERA
Towers
2
Units
132

This is a read-only view built from the filing. In your own workspace these become live — progress, spend and inventory update as your site team reports them.

Every value read from this project’s own filing. Where the record publishes nothing — construction progress, collections, sold inventory — the workspace shows an empty column rather than an invented number.

Other registered projects nearby

Same corridor, same authority. Compared on what is filed, not on what is advertised.

ProjectPromoterPricePossession
Merlin NextMerlin Group2060000 - 3300000Dec 2025
Merlin IdentityMerlin Group24900000 - 26600000—
Merlin Oikyo Phase 1Merlin Group1595000 - 3787000—
F Residences MerlinMerlin Group10500000 - 22700000—
Merlin Oikyo Phase IIMerlin Group4000000 - 4103000—
Merlin The OneMerlin Group7717000 - 22900000—
